Yosemite West Property & |
YWPHI has been awarded $304,830 provided by a National Fire Plan grant from the U.S.D.A. Forest Service through the California Fire Safe Council (FSC). The project is funded via the Cooperative Forestry Assistance, CFDA #10.664. The basis for this funding is for the support or stimulation of a public purpose under the Cooperative Forestry Assistance Act of 1978 as amended and the Consolidated Security, Disaster Assistance, and Continuing Approporiations Act of 2009, PL 110-329.
Grant Number | Total Project Cost | Funding Awarded | Matching Funds Provided | % of Match to Total Project Cost | Project Name | Project Goals |
---|---|---|---|---|---|---|
10USFS-ES321 | $304,830 | $266,830 | $38,000 * | 13% | Yosemite West Defensible Space & Shaded Fuel Break |
|
The deadline to complete all aspects of the grant is October 1, 2011.
Date | Timeline |
---|---|
February 2009 | YWPHI submits a concept paper to the California Fire Safe Council. |
May 2009 | YWPHI submits application to the California Fire Safe Council and receives grant award. |
August 21, 2009 | YWPHI attends mandatory pre-award workshop by the California Fire Safe Council. |
December 2009 | YWPHI awaits receipt of grant award documents from the California Fire Safe Council. Planning will start once the grant award documents are signed. |
January 2010 | YWPHI and fiscal sponsor sign grant award documents from the California Fire Safe Council. Federal envirnomental and cultural compliance process underway. |
May 2010 | California Fire Safe Council informs us that review of the federal envirnomental and cultural compliance process for work inside the community (Part I) is complete and work can proceed in this area only. Federal cultural and environmental compliance for areas outside the community (Part II) is ongoing and not complete, so work cannot start outside the community. |
June 2010 | YWPHI sends project information to property owners: |
June 14, 2010 | The defensible space crew starts on-the-ground work inside Yosemite West. |
August 9-20, 2010 | Work on the defensible space project will halt for approximately two weeks. The crew will tentatively resume work inside Yosemite West at the end of August. |
September 2010 | The defensible space crew resumed on-the-ground work inside Yosemite West and will continue until the work is done and/or the snow starts flying. |
September 30, 2010 | The NPS fire archeology team conducts cultural surveys on project area outside the community. |
November 12, 2010 | We completed on-the-ground work inside the community for this season, treating 71 parcels (25 houses and 46 vacant lots) and chipping approximately 2000 tons. See Participating Parcels Map below. The two-year combined participation total is 172 parcels or 60% of all parcels in Yosemite West. Work has stopped for winter and will resume in late spring 2011. |
November 16, 2010 | The California Fire Safe Council informed us that the federal environmental and cultural resource compliance review of our project for work outside the community is successfully completed. No on-the-ground work in the project area outside the community was done in 2010; this work is tentatively scheduled to be done in summer 2011. |
March 2011 | We mailed an information packet to 64 owners of 84 parcels who did not participate in the defensible space project in 2009 or 2010 with instructions on how to sign up to participate. |
May 2011 | We put out a request for bids for work inside and outside the community, select contractors, and sign agreements for same. |
June 7, 2011 | The contractor starts defensible space work inside the community. |
July 19, 2011 | The contractor starts mastication for the shaded fuel break outside the community. |
July 26, 2011 | The contractor adds a hand crew to the shaded fuel break work outside the community. |

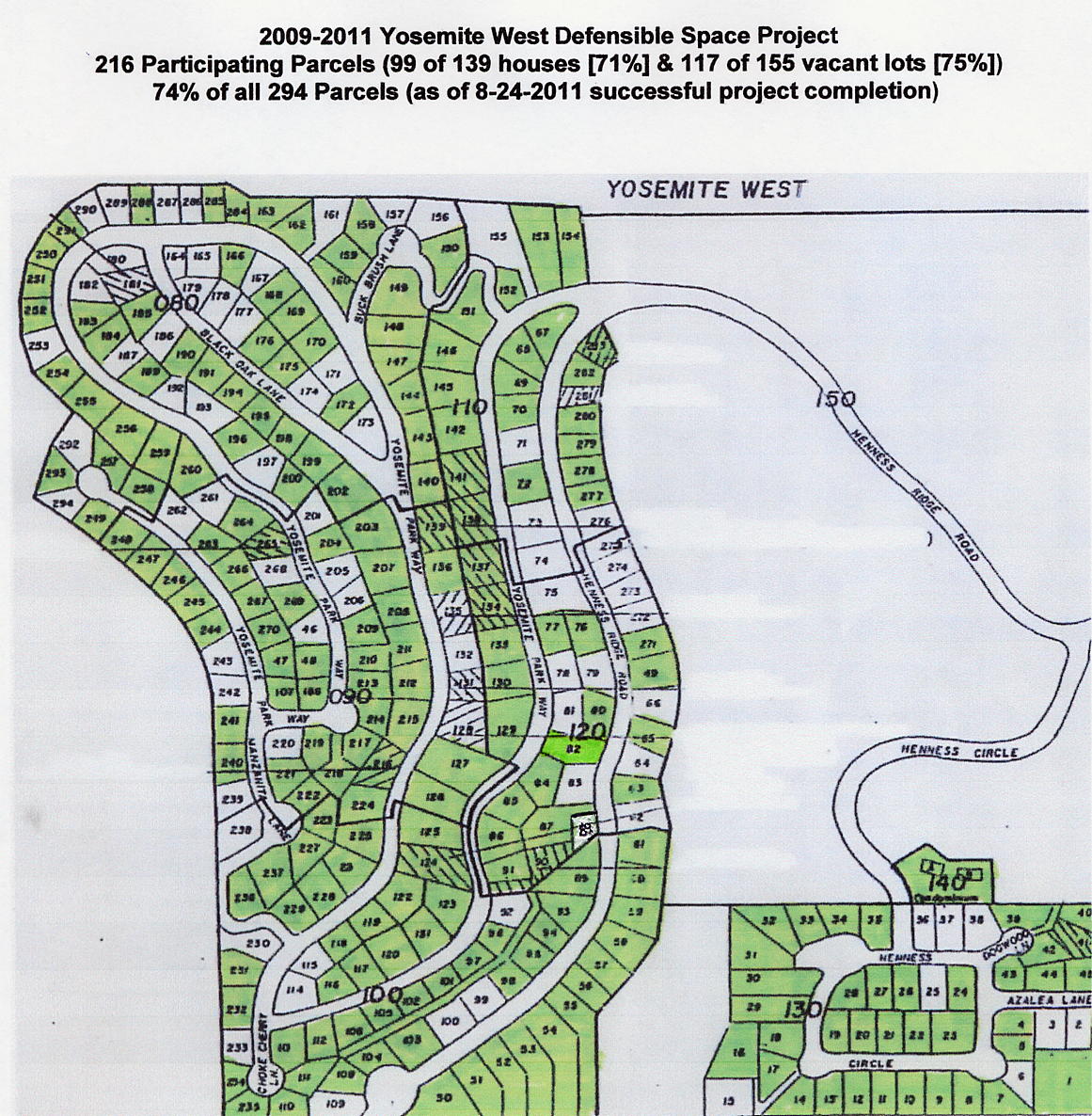

July 27, 2011 | The contractor completed on-the-ground defensible space work inside the community. This concludes all grant-funded chipping inside the community. The three-year participating parcels total 216 or 74% of all 294 parcels; 99 of 139 houses (71% of all houses) and 117 of 155 vacant lots (75% of all vacant lots). See the Project Outcomes and 2009-2011 Yosemite West Defensible Space Project map below. |
August 24, 2011 | The contractor completes all on-the-ground work both inside and outside the community. Implementation of the project is successfully completed. |
October 11, 2011 | We submitted the final progress report, photo monitoring and grant closeout report to the Fire Safe Council, and informed the project's fiscal sponsor of same. |
Project Participation Overview at completion 8-24-2011 | # Houses | # Vacant Lots * | Total # Parcels | Goal |
---|---|---|---|---|
Start of Project # Actual 2009 | 124 | 170 | 294 | |
New construction completed and occupied | 15 | -15 | 0 | |
End of Project # Actual 2011 | 139 | 155 | 294 | |
* includes 9 structures under construction and not completed nor occupied as of 7-31-2011 | ||||
2009 # Participants | 58 | 43 | 101 | |
2010 # Participants | 25 | 46 | 71 | |
Subtotal: | 83 | 89 | 172 | |
2011 # Participants | 16 | 28 | 44 | |
Total # 2009-2011 Participating Parcels **: | 99 | 117 | 216 | 73.5% |
** excludes 6 parcels where owners gave permission but not treated due to access issues | ||||
as % of Total Participating Parcels | 46% | 54% | 100.0% | |
as % of Total Parcels | 34% | 40% | 73% | |
as % of Total Houses | 71% | |||
as % of Total Vacant Lots | 75% | |||
2009 Grant Goals # Participants | 45 | 45 | 90 | |
2010 Grant Goals # Participants | 74 | 73 | 147 | |
Total 2009 & 2010 Grant Goals: | 119 | 118 | 237 | 80.6% |
Grant Goal Exceeded / (Not Met) | (20) | (1) | (21) | -7.1% |
During spring 2011, we contacted property owners with details of the defensible space project with participation details. We will be targeting property owners who did not participate in 2009 or 2010. The fuel reduction to be conducted under the grant includes removing and chipping ladder fuels, coniferous trees less than 6 inches in diameter at breast height, and shrubs and trees near driveways and parking areas to create more vertical and horizontal spacing between shrubs and trees.
The grant funding cannot cover all the fuel reduction that needs to be done. Property owners need to address the following fuel reduction tasks with their own labor and/or at their own expense:
Defensible Space Grants Overview | |||||
---|---|---|---|---|---|
Fuel Treatment Description | 2009 Grant Goal | 2009 Grant Actual | 2009 Grant Goal Exceeded | 2010 Grant Goal | Total Goal (Approximate) |
% parcels | 30% | 35% | 5% | 50% | 80% |
# parcels | 90 | 101 | 11 | 147 | 237 |
# parcels with houses | 45 | 58 | 13 | 74 | 119 |
# vacant parcels | 45 | 43 | (2) | 73 | 118 |
# acres | 36 | 37 | 1 | 55 | 91 |
% acres | 30% | 34% | 4% | 50% | 80% |
Site Map Copyright text © Yosemite West Property & Homeowners, Inc. 2003-2017. Copyright photographs © John Mock 2004-2017. All rights reserved. Unauthorized redistribution of this document is prohibited. Updated December 28, 2016. |
